          3238


          Proceedings of the 18


          th


          International Conference on Soil Mechanics and Geotechnical Engineering, Paris 2013


          extent 50 m beyond the landfill boundary or the site boundary


          whichever occurs first.  At the landfill boundary within the site,


          the capping will be keyed in with a sump installed for leachate


          and landfill gas condensate collection.


          7 LESSONS LEARNT DURING CONSTRUCTION


          Where the landfill extends over the site boundary a bentonite


          plug will be installed at the boundary to minimise migration of


          landfill gases through soils, refer to Figure 6.


          Of particular interest to those wanting to apply the techniques


          described in this paper for another site or project, are the lessons


          learnt during the construction of this project.  Primarily, these


          are as follows:


          Landfill gas drainage will consist of a gas drainage layer


          forming part of the cap.  Collection pipes will be placed around


          the perimeter and across the benches with a maximum spacing


          of 50 m.  An additional gas extraction filter layer and pipe work


          for the collection and discharge of LFG will be incorporated


          beneath the slab of all buildings where possible.  Three remedial


          options for the management landfill gas were considered.  The


          use of landfill gas for power generation was not considered


          feasible due to low gas flows as result of the age and stage of


          the decomposition of the waste present at the site this option


          1. The site was located within 50m of a main highway.  A


          hazard was ‘fly rock’ being mobilized during dynamic


          compaction and hitting operators or leaving the site and


          colliding with a vehicle on the highway.  To control this


          hazard, a no-go zone was established around the dynamic


          compaction rig and the rig was not allowed to operate


          near the highway.


          2. The extent of consolidation during dynamic compaction was


          significant.  At this site, the contaminated water make


          during dynamic compaction was also significant.  Whilst


          this was predicted and readily catered for onsite (in


          accordance with the CEMP) it took a considerable amount


          of time to manage, sample for contamination and then


          subsequently discharge at an appropriate location.  It was


          also relatively expensive.


          3. The use of coal washery rejects, a mining by-product from


          the coal washing process, was entirely successful.  This


          material was put to use on this site and would otherwise


          have ended up as landfill.  The ability to use what would


          otherwise have been waste material, as fill material in the


          overall remediation of another landfill site, is considered


          best


          practice


          and


          an


          outstanding


          outcome


          environmentally.


          4. The selection of an earthworks contractor must include an


          assessment of their ability to perform the work rapidly.


          Exposing the waste sections of the site created many


          hazards, and the contractors ability to perform the work


          and ‘cap’ the site ready for dynamic compaction in the


          shortest possible timeframe greatly reduces the exposure


          to those hazards and any expensive delays caused by (for


          example) inclement weather.

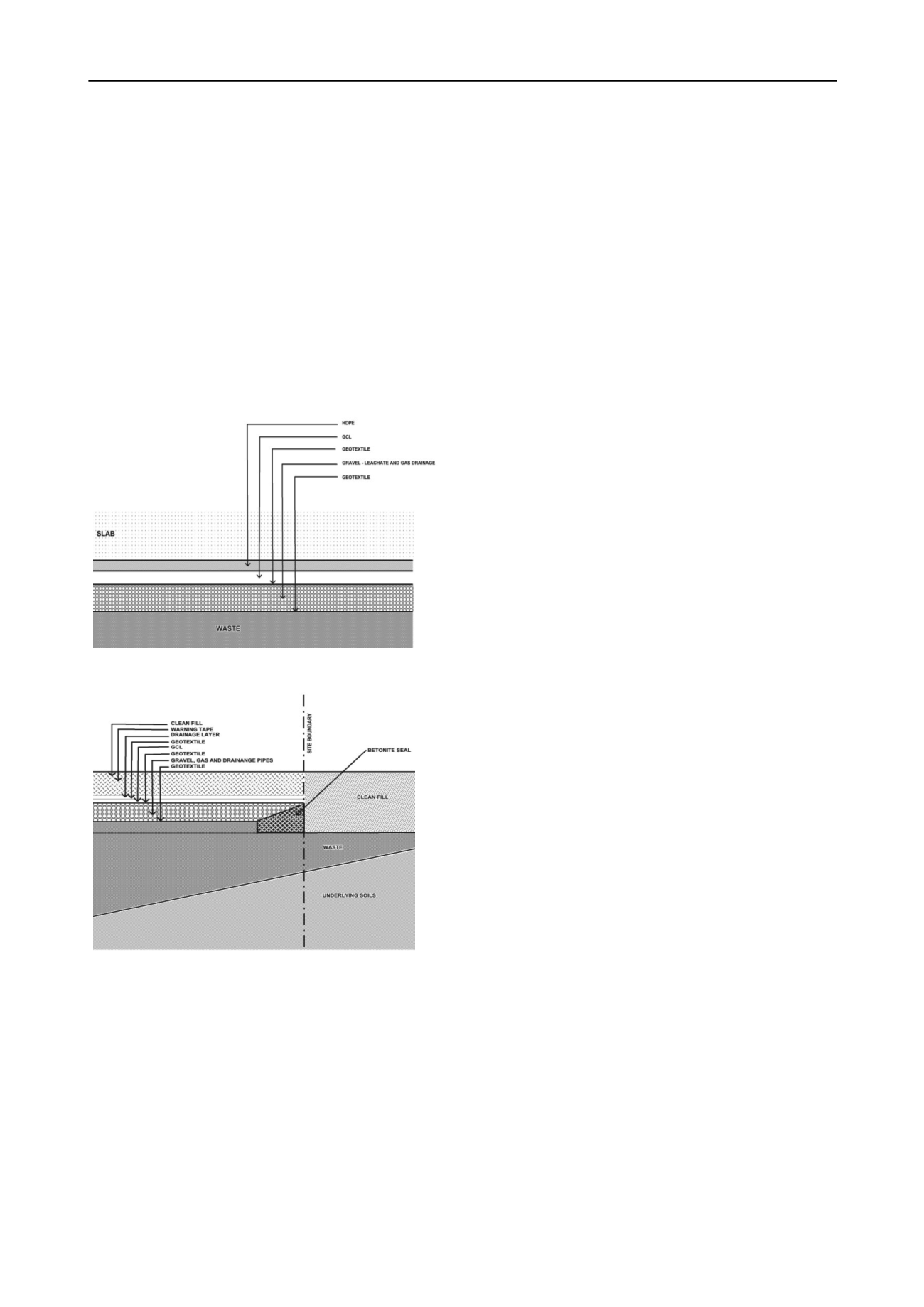

            Figure 5: Preliminary design of cap for slab on ground



          8 CONCLUSION


          The use of dynamic compaction and construction of a landfill


          gas drainage system together with innovative civil solutions will


          allow the Fo Guang Shan Nan Tien Buddhist Order to develop


          their site and create a teaching and cultural facility as part of the


          existing Nan Tien Temple.  Geotechnical and environmental


          performance was monitored during site preparation works and


          will be monitored during building construction.


          9 ACKNOWLEDGEMENTS


          The authors acknowledge the Fo Guang Shan Nan Tien


          Buddhist Order and affiliates for assistance in the project and


          their permission to use project specific data for this paper.



            Figure 6: Preliminary design of cap at site boundary



          Flaring of the gas, with ignition of the gas as it leaves the site


          was considered, given its advantage of reducing the landfill gas


          to a higher percentage of CO


          2


          and H


          2


          O vapour, however the


          technical difficulties of operating the flare, the area required for


          a flare plant and the cost of setting up and maintenance of the


          plant, among others, far outweighed the advantages.  The final


          remedial option, venting to the atmosphere, was chosen for the


          zero requirements for a specific treatment plant and operating


          costs.  As such the preliminary design consists of the placement


          of turbine ventilator stacks around the site.  Landfill gas


          discharge will occur through stacks that will extend 1 m above


          the proposed maximum building roof level across the site.  To


          monitor the landfill gas and minimise the potential of migration


          off-site a series of monitoring wells will be installed.


          10 REFERENCES


          Standards Australia. 1993.  Determination of the penetration resistance


          of a soil – Standard Penetration Test.



            Australian Standard AS 1289



          6.3.1 – 1993.


          Standards Australia. 1996. Guidelines on earthworks for commercial


          and residential developments.



            Australian Standard AS 3798 –




            1997



          .


          Hausmann, M.R. 1990. Engineering Principals of Ground Modification.



            McGraw Hill



          .


          Thom, M.J. 1998.  The long term settlement behaviour of waste and its


          effect on future development.



            3




            rd




            National Hazardous and Solid




            Waste Convention.



          Department of Environment and Conservation NSW. 2006. Guidelines


          for the NSW Site Auditor Scheme.



            2




            nd




            Edition.
