          3236


          Proceedings of the 18


          th


          International Conference on Soil Mechanics and Geotechnical Engineering, Paris 2013


          4 SITE INVESTIGATION AND RESULTS


          4.1



            Geotechnical



          Investigations to establish a geotechnical model of the site


          included 103 test pits to depths of up to 5 m, 14 cored boreholes


          to depths of up to 12 m and the installation of 8 standpipe


          piezometers.  In summary, the natural geological profile of the


          site comprised topsoil over residual clays with latite and


          sandstone bedrock (generally of medium to high strength)


          below depths of 1 – 1.5 m.  The profile of the landfill included a


          coal washery rejects (CWR) and clay capping layer some 0.5 –


          3.5 m in thickness (but generally less than 1 m) with the depth


          of the waste in the order of 4 – 12 m.


          The landfill waste was interbedded with CWR and clays, as


          was expected given the conventional operation of a putrescible


          waste facility.  The density of the landfill was generally loose


          with some denser sections as reflected by standard penetration


          test “N” values in the range 2 – 30.  Perched water tables were


          also present.  The extent of the landfill is shown in Figure 1.

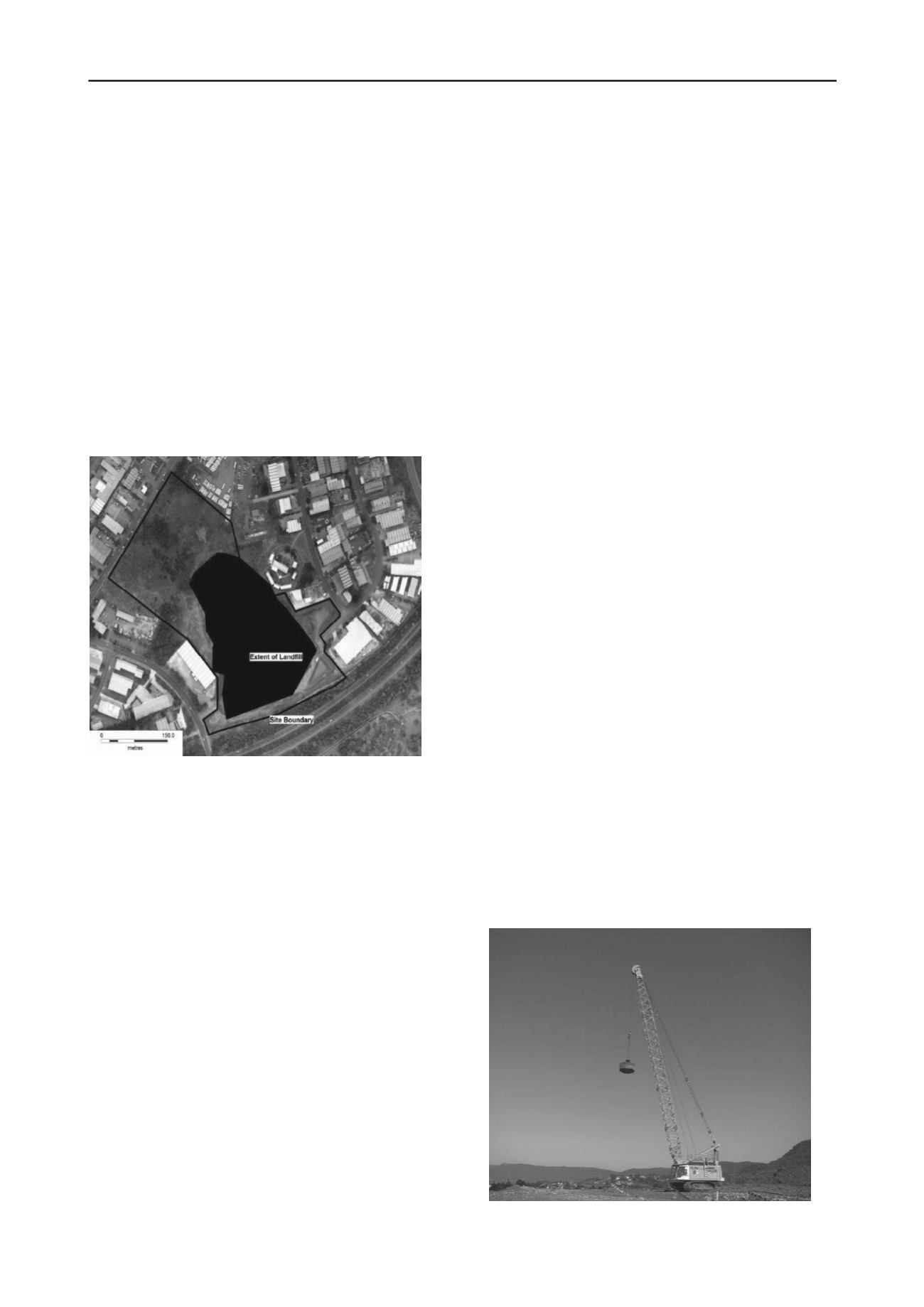

          Figure 1. Extent of landfill.


          4.2



            Environmental (soil, water, air, noise)



          180 test locations were investigated across the site, most of


          which were in the landfill footprint.  Contaminant


          concentrations were compared to the NSW DECC (2006)


          Health based Investigation levels.  Within the soils, elevated


          levels of manganese and hydrocarbon (C10 – C36) were


          recorded.  Testing of groundwater indicated elevated levels of


          iron, manganese, ammonia, nitrate and total phosphorus, typical


          of levels and contaminants found in landfill leachate.  Methane,


          hydrogen sulphate and carbon dioxide were recorded in the gas


          monitoring wells with the methane levels within either the


          “explosive” range or exceeding the “explosive limits” and in a


          range that may cause asphyxiation.


          In the areas outside the landfill footprint, no environmental


          concerns were recorded apart from random dumping of


          uncontrolled fill which was managed by conventional


          construction practices.


          5 GROUND CONSOLIDATION WORKS


          Site preparation was completed in March 2011 and included


          construction of a temporary leachate collection system,


          reshaping and benching of most of the site, dynamically


          compacting the landfill and undertaking of controlled


          earthworks to achieve design levels.  Monitoring of air quality,


          noise, vibration levels and leachate was ongoing during the


          works.


          5.1



            Civil Design and Leachate Control



          During initial site works, the expectation was that a relatively


          significant quantity of leachate would discharge from the


          landfill cell which would reduce after dynamic compaction.


          The reduced quantities were expected to be treated and


          managed long term by a membrane bio-reactor (prior to


          discharge off site or re-use on site).  As the bio-reactor could


          not be sized to cater for the high loads during site preparation


          works, a 2ML leachate pond was constructed downslope of the


          landfill cell.  Leachate was fed into the pond via a 2 m


          groundwater cut-off trench installed around the toe and flanks


          of the landfill cell.  Once in the pond, leachate was then pumped


          through a treatment system consisting of pumps, sand filters,


          activated carbon filters and an automatic sampler prior to


          discharge into the sewer system via a Trade Waste Agreement


          with Sydney Water.


          The leachate pond was designed to not only suit its purpose


          during dynamic compaction and site preparation (i.e. as a


          leachate pond), but to also double as an on-site detention (OSD)


          pond during the life of the Institute.  This OSD pond assists


          with long-term management of stormwater on the site.  The


          HDPE liner installed in the leachate pond during dynamic


          compaction was removed and the pond readily transformed for


          the OSD purpose.  This saved having to build two very similar


          structures twice.


          5.2



            Dynamic Compaction



          In order to improve the density of the landfill (and thus to


          improve longer term performance by limiting primary


          compression and secondary consolidation following progressive


          waste decomposition), dynamic compaction was selected as the


          appropriate method.  The equipment (shown in Figure 2)


          included a 120 tonne crawler crane dropping a 25 tonne pounder


          from a height of (nominally) 20 m.  Compaction was carried out


          in two phases.  Following placement of a coarse “compaction


          layer” to provide stability for the crane, the primary phase


          comprised multiple drops of the concrete pounder (typically 3 –


          4) on a 6 m x 6 m grid with the craters backfilled as the


          compaction proceeded.  The final (or ironing) phase was carried


          out using a pounder of similar mass but a larger footprint (5 –


          9 m2) with a drop height adjusted to the pounder size and


          compression achieved.


          Using the methods of Hausmann (1990), an assessment was


          made of the degree of ground improvement with surface


          settlements of generally 1 – 2 m expected in the areas underlain


          by the deeper landfill.  The survey results following completion


          of dynamic compaction and were predominantly within the


          range 0.5 – 1.5 m, in line with expectations and generally 10 –


          12% of overall landfill depth.


          Figure 2. Dynamic Compaction Equipment.
