          808


          Proceedings of the 18


          th


          International Conference on Soil Mechanics and Geotechnical Engineering, Paris 2013


          Proceedings of the 18


          th


          International Conference on Soil Mechanics and Geotechnical Engineering, Paris 2013


          4

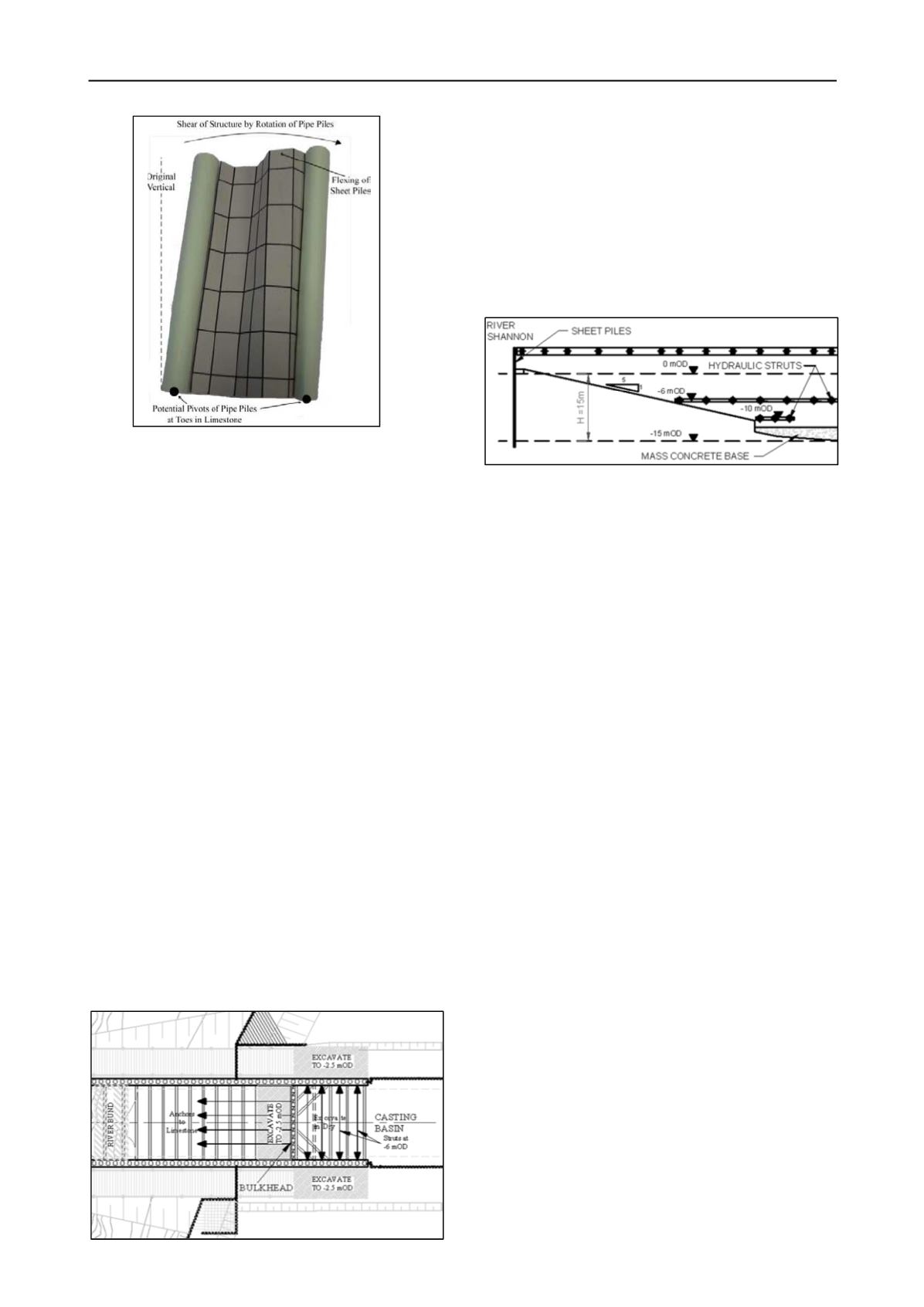

          Figure 9 Model to illustrate potential “shear” mechanism


          5 CHANGES TO CONSTRUCTION OF FLOAT-OUT


          SECTION


          Design calculations had indicated that excavating north of the


          bulkhead in the dry would lead to excessive moments in the


          piles.  It was therefore intended to install temporary sheet piles


          between this area and the casting basin, and to excavate and cast


          the base slab under water.  During construction of the southern


          cut and cover section, considerable difficulties were


          experienced maintaining a suitable surface for underwater


          casting of the base slab, due to large volumes of suspended silts


          slowly settling there.  In addition, excavation underwater,


          although practicable, was much slower than excavating in the


          dry.  It was therefore decided to develop a strategy for


          excavating north of the bulkhead in the dry.


          By this time considerable experience had been gained in


          construction of the casting basin.  Although not as deep as the


          two structural sections, it was a substantial excavation in its


          own right.  It was retained by sheet piles with anchors at high


          level, inclined at 45°.  Despite the free length of up to 30 m


          through soft clay, installation into the limestone to achieve a


          working anchor load of 1 MN had become reasonably routine.


          The sheet piles were also retained by struts below the casting


          basin floor.  Before the permanent struts were installed, the


          walls were supported by temporary hydraulic struts.


          A combination of these techniques was adopted for the


          float-out section.  The key to their success was the reduction of


          the external soil and water forces on the walls.  This was


          achieved (Figure 10) first by constructing a bund at the far


          southern end of the section to prevent the river from acting


          against the bulkhead.  Then 2.5 m deep excavations were made


          outside each wall.  Temporary struts were installed between the


          side walls at -6 mOD, and anchors installed at the same level in


          the bulkhead.


          This operation demonstrated again how much easier


          excavation was in the dry rather than underwater.This factor,


          together with a change in the design of the permanent tunnel


          works, led to a requirement to excavate in the dry on the river


          side of the bulkhead also.  A construction sequence was devised


          (Figure 11), which again involved the use of temporary struts


          (this time at two levels), the exclusion of the river by means of


          bunds outside the walls, and the reduction of ground level


          outside the walls.  Other features were a sheet pile wall across


          the open end of the excavation, a 1:5 slope down from the sheet


          pile wall, and a 3 m thick mass concrete slab at -12 mOd as


          permanent works to support the northernmost tunnel unit.


          Figure 11. Section through new construction measures


          These proposals were set out on a colour-coded plan, to


          facilitate their checking by the design consultants.  The


          checking led to some minor changes in detail, and to the


          identification of one potential major problem.  This involved the


          stability of the end slope, which although only 1:5, would be


          15 m high after excavation for the mass concrete slab.  A simple


          calculation using Taylor’s curves demonstrated that an average


          shear strength of 33 kPa was required to achieve a safety factor


          of 1.3 against undrained failure, considerably greater than the


          design values (Figure 4).  The slope was therefore flattened still


          further, to about 1:8.  Its toe was raised to -6 mOD, and further


          excavation at the toe supported by an anchored sheet pile wall.


          These works were successfully implemented, and float-out


          of the first tunnel unit took place on programme on 7th


          September 2008.


          6 CONCLUSIONS


          Successful construction of the Limerick Tunnel enabling works


          was achieved despite the complexity of the structures and the


          challenging nature of the ground conditions.  Technically, one


          of the most important factors was that the forces on the


          structures were dominated by water and ground levels, and


          therefore that significant advantages could be achieved if these


          levels could be controlled and hence varied.


          Most of the analyses were carried out using


          industry-standard software.  Simple calculations for force and


          moment equilibrium slope stability proved also to be of great


          value.  Perhaps more important than the calculations was the


          identification of mechanisms that needed to be analysed.  Tools


          to aid understanding of these included isometric diagrams


          (Figure 6), graphs (Figure 8), a physical model (Figure 9) and


          colour-coded plans.  Such simple but effective tools enabled


          designers and constructors to achieve a common understanding


          of the project and hence its successful completion.


          7 REFERENCE


          Buggy, F. And Peters, M. 2007. Site investigation and characterisation


          of soft alluvium for Limerick Southern Ring Road – Phase II,


          Ireland.



            Proc. IEI Conference on Soft Ground, Port Laoise,




            paper 1.6



          .


          Figure 10. Measures adopted to enable construction in the dry
