          3354


          Proceedings of the 18


          th


          International Conference on Soil Mechanics and Geotechnical Engineering, Paris 2013



            Proceedings of the 18




            th




            International Conference on Soil Mechanics and Geotechnical Engineering, Paris 2013



          some distance from the excavation. This might reduce the draw-


          downs in the centre of the pit.


          The chosen groundwater lowering system consisted of a


          combination of well-points, bored wells and a drainage system


          beneath the membrane.


          The well-points were closely spaced at approx. 6 meters depth


          at the perimeter of the pit to deal with the groundwater flow in


          the upper layers of sand.


          In addition eight bored wells were placed at the perimeter to


          deal with the deeper water built-ups. Besides pumping from the


          wells vacuum was applied to the wells to reduce pore water


          pressures in the soil and increase the effective stresses in the


          soil, at least to some distance from the wells.


          Furthermore, a well in the centre of the pit was performed to


          prevent uplift. This well was initially installed with a pump, and


          during excavation the well was successively cut down to


          excavation level and the pump was removed.


          Before covering up the bottom and the sides with the


          membrane, a drainage system in connection with the (weeping)


          well was established in the bottom. To prevent a lifting problem


          caused by accumulation of water beneath the membrane,


          pumping on the drainage system was made possible by


          traditionally well pumps mounted through two installed pipes


          laid in inclining ditches up the sides.


          Pumping from the drainage system, the well-points and the


          bored wells at the perimeter of the pit was sustained until the pit


          was filled with water unto the measured highest natural ground


          water level approx. 1 meter below the surrounding level.


          4.3



            Soil handling



          The excavated soil had to be built-in in the embankments


          around the pit. The soil mainly consisted of clay, where


          moisturing/weathering normally must be avoided in order to


          obtain reasonable compaction (more than 95 % Standard


          Proctor) and confined deformations of the embankments.


          Therefore, the earth works must take place during a period with


          favourable weather conditions, which in Denmark means the


          summer period.


          Furthermore, the poor strength properties of the marine clay


          of high plasticity


          –


          especially in a remoulded condition - was


          dictating that the clay only had to be rebuilt in areas where the


          requirements to the soil were less critical.


          4.4



            Consequences of thermal influence to the soil



          In the operational phase the temperature in the adjacent soil will


          increase, maybe up to 90°C close to the pit. This heating of the


          soil might cause a drying-up effect of the soil above the ground


          water table if no water is added from e.g. precipitation. In the


          actual case the clays seemed so preconsolidated that the natural


          water content was considered to be close to the shrinkage limit.


          Consequently the risk of development of a long term


          deformation problem was evaluated as a minor issue.


          5 CONSTRUCTION PHASE


          The PTES was established during the summer 2011 which


          happened to be very wet with precipitation more than twice the


          normal precipitation. In addition, a cloudburst occurred with


          more than 100 mm precipitation overnight which caused


          damages to the just finished surfaces and obstacles for the


          subsequent works. Consequently, the construction period was


          delayed 3 months into the winter.


          This entailed that the preconditions for the project was


          severely challenged. Especially the maintenance of the stability


          of the sides was alarming. The predicted long term problem


          with poor drained strength parameter might be worsened if the


          efficiency of the ground water lowering system was reduced


          (due to clogging etc.). This problem period was not to end until


          the filling-in of water was above the surrounding ground level.


          In spite of this no severe ruptures were recorded. Figure 6


          shows a photo of the pit at a late stage of the excavation work.

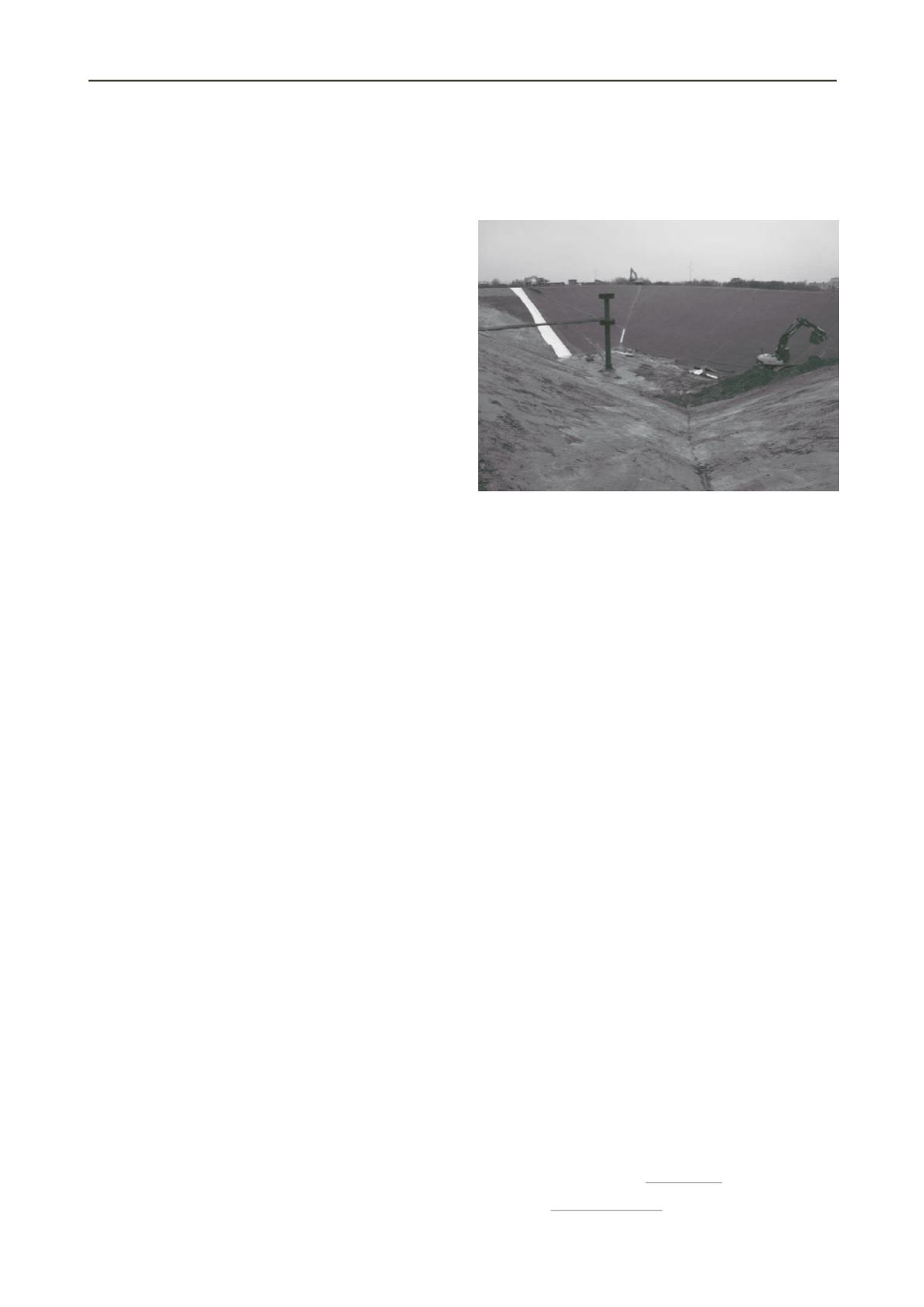

          Figure 6. Photo of pit during completion of excavation and laying out of


          the membrane in progress. The tower in the centre of the photo is a 16


          m tall water in- and outlet for the operational phase of the PTES.


          6 CONCLUSIONS AND PERSPECTIVES


          The PTES project in Marstal has demonstrated that a thermal


          energy storage with 75,000 m


          3


          water is obtainable in connection


          with solar heat based district heating systems. The construction


          cost of the Marstal storage was 41


          € per


          m


          3


          of water (exclusive


          VAT) including all pipe connection to the plant, control system,


          geotechnical support, etc. The construction cost also includes


          research and development costs of the storage and different lid


          designs. The costs are cost-competitive compared to other


          storage systems (e.g. TTES, ATES and BTES) and there is a


          potential to bring the costs further down.


          The project has encountered difficulties in matters of soil and


          ground water conditions and challenges due to circumstances in


          the actual climate, but these challenges has been dealt with in


          order to minimize the costs of the PTES. Details in the project


          still needs to be optimized, but the project is a stepping stone in


          the development of the necessary techniques for decreasing the


          use of renewable energies.


          The aim of the authors of this article is to pinpoint the


          challanges to be encountered during planning and execution of a


          PTES illustrated by an actual project.


          It is the authors’


          perception that a PTES is applicable for a lot of sites.


          Denmark has approximately 400 district heating plants of


          varying size. Most of these plants are placed in rural areas,


          where establishment of solar heating plants supplemented by a


          PTES is an obvious solution. As an example the planning of a


          60,000 m


          3


          PTES in connection with 35,000 m


          2


          solar heat panels


          at Dronninglund Destrict Heating in Denmark is ongoing and


          will presumable be established in 2013 - 2014. Some


          PTES’s


          have been established in other countries, e.g. Germany, but


          none as large as in Denmark.


          7 REFERENCES


          GEO Danish Geotechnical Institute 2010-2011. Geotechnical reports for


          establishment of a PTES in Marstal (not published).


          Mangold D, Schmidt T, The next Generations of Seasonal Thermal


          Energy Storage in Germany,




          Marstal District Heating 2010-2012. Monthly solar heat production and


          radiation,



          .


          Verein Deutscher Ingenieure 2004, 4640 Blatt 4.
