          3253


          Technical Committee 307 /



            Comité technique 307



          3 CONSTRUCTION PROCEDURE  AND


          INSTRUMENTATION.


          The walls construction process was conducted using the moving


          formwork technique, which is a common method for the


          construction of wrapped-faced walls in the field. In order to


          reduce the side wall friction, the whole internal walls of the test


          facility were covered with three polypropylene sheets


          interspersed with lubrication (liquid silicone).


          Three walls sections were named according to their cardinal


          orientation as West, Central and East. This configuration allows


          for the instrumented portion of the wall (Central section) to


          approach a plane-strain condition, free from side wall effects, as


          far as practical. This procedure has been adopted at Royal


          Military College of Canada (RMC) in a successful long-


          standing program on construction of full-scale reinforced walls


          (Santos et al. 2010).


          The construction procedure consisted of placing the backfill


          material and compacting it in 200mm lifts. In order to provide a


          light compaction and a satisfactory surface leveling, a manual


          compaction roll was used. Near to the face, a hand tamping


          cylinder was used to minimize the effects of the compaction on


          the facing displacements. The total construction time was 29


          days. Figure 4 and Table 3 present RCDW reinforced walls


          construction history and their main characteristics.

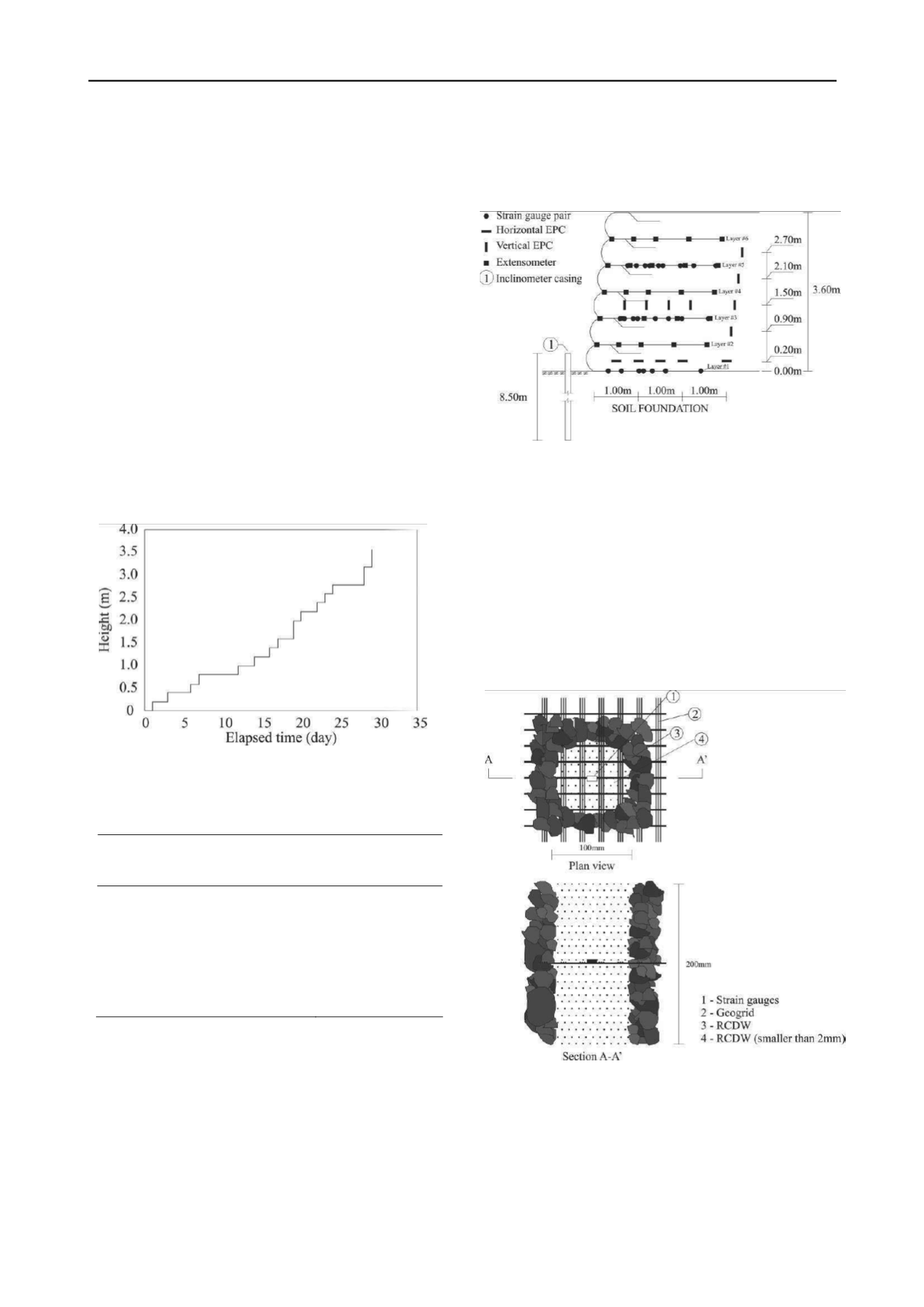

          Figure 4. RCDW reinforced walls construction history (Santos et al.


          2010).


          Table 3. Main walls characteristics.



            Value



          Characteristic



            Wall #1




            Wall #2



          Geosynthetics


          Geogrid Geotextile


          Height (m)


          3.60


          Facing batter (°)


          13


          Reinforcement spacing (m)


          0.60


          Reinforcement length (m)


          2.52


          Approximately 400 instruments were installed in the two


          walls in order to record the following:


          a. strain in reinforcement layers (strain gauges and wire-


          line extensometers installed in wall #1 and wall #2,


          respectively);


          b. wall face displacements;


          c. vertical earth pressure at the base of the RCDW (earth


          pressure cells - EPC);


          d. horizontal earth pressure within the RCDW mass


          (EPC);


          e. settlements along the surface of the RCDW mass


          (superficial marks);


          f.


          horizontal displacement of the foundation soil


          (inclinometer).


          Figure 5 shows the instrument distribution profile.


          Figure 5.Instruments distribution profile.


          Additional procedures were necessary to protect the


          instruments devices against mechanical damages during the


          walls construction. Because of the presence of coarse grained


          particles (Figure 2), the installation of the instrumented geogrid


          layers and earth pressure cells (EPC) were carried out using fine


          grained particles around the instruments. PVC tubes were used


          to create a region with selected fine RCDW - smaller than 2mm


          around EPC and strain gauges. Figure 6 presents a scheme of


          the region around strain gauges after geogrid layer installation


          process.


          Figure 6.Region around strain gauges (wall #1).


          The data recording after the walls construction revealed that


          just one strain gauge was mechanically damaged, which


          correspond to a survival level of 98% for installed strain gauges.


          This survival level kept stable until the end of research program


          even though the rainy seasons in Brasília. It was observed that


          all EPC survived to installation process but not to the first rainy


          season. After 110 days, all EPC failed.


          Outward displacements of the walls faces during


          construction were measured. It was observed for the wall #1
