          1761


          Technical Committee 204 /



            Comité technique 204




            Proceedings of the 18




            th




            International Conference on Soil Mechanics and Geotechnical Engineering, Paris 2013



          sch


          by 2 m work segments.


          ually.


          ments of existing footings, exceeding the 10 mm admissible


          value.


          It was decided not to take into account existing piles made in


          2005. This decision was based on two facts.


          Firstly, the static load tests on existing piles showed great


          scatter in results. In fact, bearing capacity was two times lower


          then its design. Secondly, the connection of reinforced concrete


          capping beam to existing foundation made of crushed stone was


          questionable. Assesment of existing foundation and its structural


          integrity confirmed that the major part of the building load still


          transfered through existing strip foundation despite the presence


          of underpining piles.


          With regard to aforementioned facts, a decision was made to


          cancel piling from the analyses to ensure a safety margin.


          There were considered various trench retaining options: root


          piles, pressed-in piles, subsoil stabilization that could be techni-


          cally possible in congested basement premises.  However, none


          of the existing methods could resolve the above issues and en-


          sure an adequate safety margin. Fast fabricated root piles usually


          have technological  settlements unacceptable for the building in


          question.  Pressed-in piles, having no such disadvantage, were


          used for the Bolshoi Theater refurbishment project, but they


          proved to be very labor intensive, and their installation


          required much more time than the time, remaining before


          the P.I. Tchaikovsky Competition. Subsoil stabilization is not a


          sufficiently safe solution, as in such soils it was difficult to en-


          sure adequate quality of respective construction  operations.


          In view of all above mentioned circumstances a decision


          was made to support 4.0...4.5 m ducts with root piles, reinforced


          with steel pipes.


          Realization of the project required a technique and a se-


          quence of the underground operations, which would minimize


          the construction the


          impact of construc-


          tion works on the


          building


          structure


          (Petruknin V.P. et al.


          2011). At the initial


          stage the soil was


          grouted with Micro-


          dur suspension, then


          the supporting root


          piles were erected


          (Figure 6), followed


          by stagewise soil


          excavation to design


          depths and raft con-


          creting, only then the


          duct walls and the


          floor were erected.

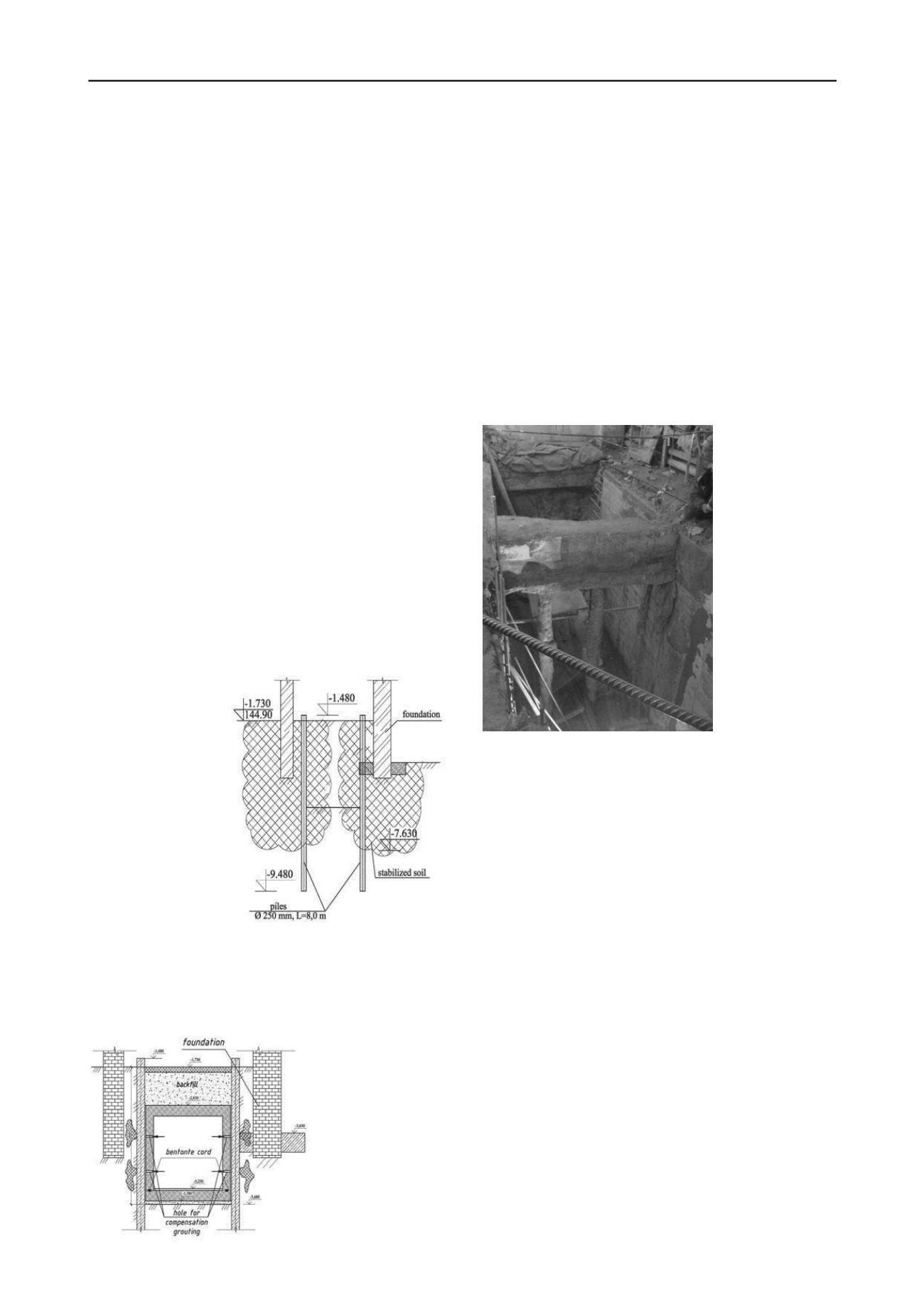

          Figure 6. Soil stabilization layout and retaining piling


          The reafter, in order to change the subsoil stress and strain


          behavior multiple compensation grouting was done behind the


          trench lining (Figure


          7). Geodetic monitor-


          ing of the footing


          settlements showed


          that the resulting


          upheaval of markers


          was up to 2…3 mm.


          Figure 7. Duct concret-


          ing layout with the com-


          pensation grouting


          eme


          As is known the root piles’ advantage is their low cost and


          fast erection, the only drawback is the respective technological


          settlements of footings, which can be as much as several centi-


          meters (Shulyatjev O.A. et al, 2008; Petrukhin V.P. et al, 2008).


          In order to exclude technological settlements due to root piling


          there were performed tests, and a drilling set-up was developed,


          protected by a RF patent (Petrukhin  V.P., Popsuenko I.K., Shu-


          lyatjev O.A., 2011), that compensated soil stress-strain behavior


          variation due to drilling by stagewise vertical pressurizing to-


          gether with  filling the  bore hole with cement-sand grout, whose


          composition excluded sedimentation. The operations were per-


          formed gradually


          According to the above mentioned patent the hole drilling


          was accompanied by compaction and hole walls troweling to


          prevent water-saturated liquefied soil falling in the borehole.


          Figure 8 shows a photograph of a duct segment under the Big


          Hall, dug out manually to the design depth.


          At  the fore-


          front root piles,


          made in 2005, are


          visible, they are


          joined together by


          a concrete raft, they


          are a sort of struts.


          Soil


          excavation


          from ducts is a


          rather


          labor-


          intensive process,


          therefore, as di-


          mensions of the


          premises


          were


          small, the soil was


          dug out man


          Figure 8. 4.5 m deep service duct


          In order to reduce footings settlements during ducts mining


          operations the soil under bearing walls was grouted with “Mi-


          crodur” suspension.


          Therefore, the subsequent soil excavation showed that soil


          stabilization had been done adequately, however, practically no


          traces of grouting were discovered at some points in spite  of the


          customer permanent strict control and designer  supervision.


          Thus, it indirectly proved that the safer selected option i.e., re-


          taining piles, was correct.


          Soil mining under bearing walls of the building was a com-


          plicated issue. As is mentioned above, it is wrong during soil


          mining to rely on earlier arranged root piling.   Therefore, a steel


          frame set-up was elaborated for 4,5 m deep ducts, which sup-


          ported a part of the wall, under  which the soil was dug out.


          Mining 1,8 deep ducts was even more difficult. Notably,


          shallow ducts mining was performed not only in soil,  it was


          often done along the  body of rabble stone footing (the footing


          width was up to 1,5 m), therefore, soil excavation looked as


          non-mechanized mining (all operations were manual).


          Underground development project involved various geo-


          technical operations that required on-line integrated geotechnical


          monitoring, performed by a specialized company in the most


          optimal way. Moreover, the designer company (Gersevanov


          NIIOSP) carried out their own supervision of the vertical and


          lateral displacements of the footings and of the Conservatory


          building  structure. The congested conditions of the refurbish-


          ment  operations, numerous labor force, multiple material stor-


          age sites, etc. restricted installation of an up-to-date on-line set-
