          1334


          Proceedings of the 18


          th


          International Conference on Soil Mechanics and Geotechnical Engineering, Paris 2013

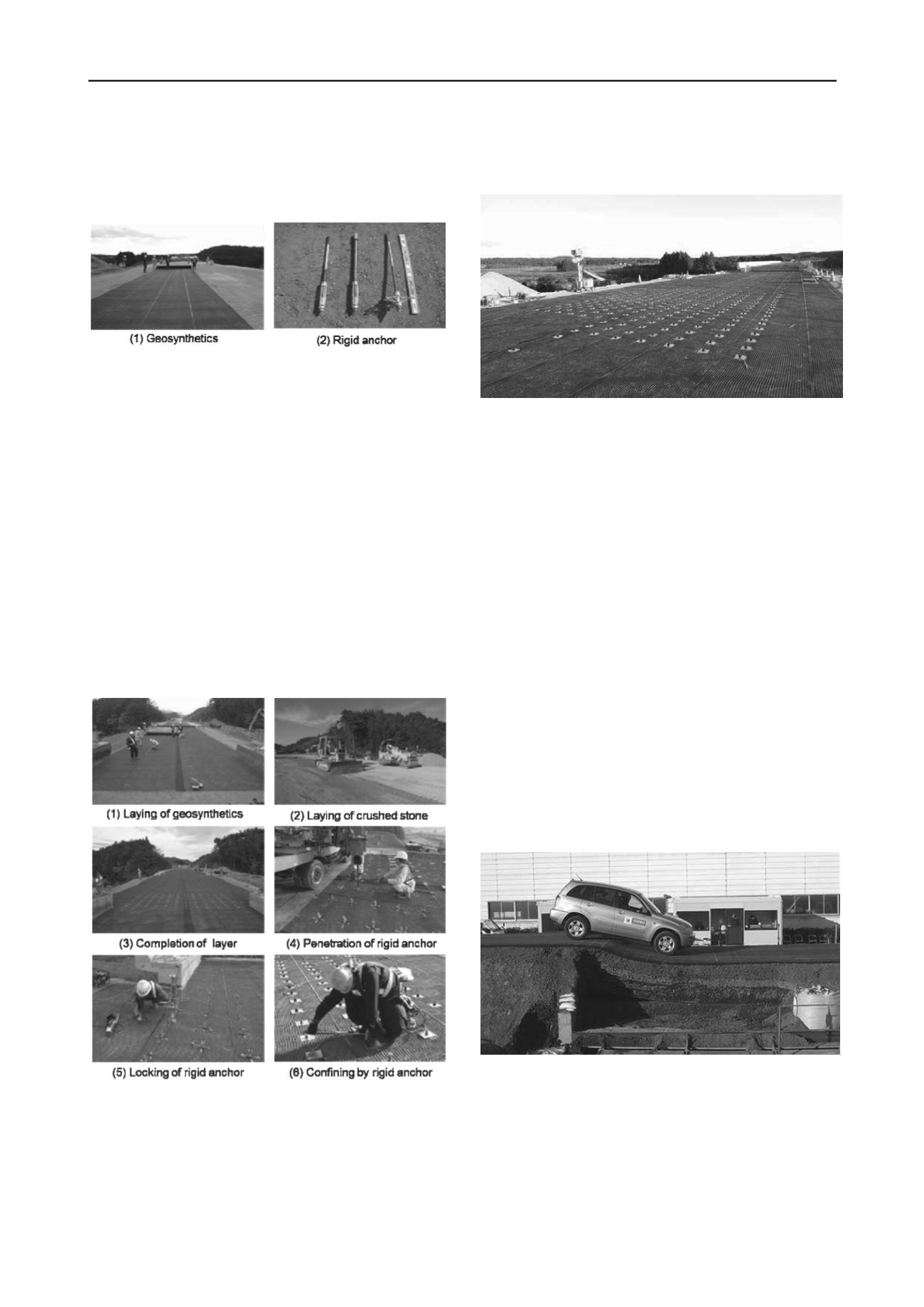

          Photograph 1 (2) shows the newly developed post-tensioning


          rigid steel anchor used in CRE.  This anchor was improved


          from a slope reinforcement anchor. The  anchors is vertically


          penetrated from the top to the bottom layer and locked to the


          lower geosynthetics.


          Photographs 1. Geosynthetics and confining rigid steel anchors using


          Confined-Reinforced Earth.


          3 CONSTRUCTION METHOD


          Photographs 2 show the construction sequence of CRE. After


          preparing the lower subgrade, the 1


          st


          layer of geosynthetics is


          laid on the area to be reinforced (Photograph 2 (1)).


          Then crushed stones are carefully laid by a bulldozer or by a


          motor grader (Photograph 2 (2)) on the 1st layer of


          geosynthetics and the layer of crushed stone is fully compacted


          by vibrating rollers (Photograph 2 (2)).  After placing three


          layers of compacted crushed stone and laying of 2


          nd


          ,3


          rd


          and 4


          th


          layers of geosynthetics (Photograph 5 (3)), rigid steel anchors


          are vertically penetrated from the top to the bottom layer by the


          small pile driving equipment (Photograph 2 (4)) and


          mechanically locked to the lower geosynthetics employing a


          small hydraulic jack ( Photograph 2 (5)).


          It should be noted that the construction time of setting


          anchors is very short (about 40 to 50 anchors per hour).  Finally,


          a top steel plate is set through a rod and is fixed to the rod


          Photographs 2. Construction method of Confined-Reinforced Earth.


          (Construction in Joban Highway in Fukushima, Japan, 2011)


          with a nut using a torque wrench (Photograph 2 (6)).  Confining


          load of 30kN can be exactly maintained by setting torque. By


          use of this construction method, rapid construction of CRE


          becomes possible making it practical enough to apply this CRE


          for road in service. Photograph 3 shows the application of CRE


          for seismic retrofit of asphalt pavement on the actual highway


          embankment in Joban Highway, Fukushima, Japan, constructed


          in 2011.


          Photograph 3. Application of Confined-Reinforced Earth for actual


          highway embankment  in Joban Highway, Fukushima, Japan, 2011.


          4 FULL SCALE IN-SITU TEST



            4.1 Trial embankment



          A full-scale test of this high rigidity reinforced earth was carried


          out in the field in Ibaraki, Japan, from 9


          th


          to 16


          th


          March 2011 as


          shown in Photograph 4. The constructed trial embankment was


          of 25m length, 4m width and 2.5m height at the top of


          embankment. Full-scale asphalt pavements were placed on the


          trial embankment. The asphalt concrete pavement consisted of


          asphalt concrete of 50mm thickness and base course of 300mm


          thickness. Two types of asphalt pavement were constructed. The


          first type was conventional asphalt concrete pavement placed on


          the compacted soil subgrade, while the second was asphalt


          pavement placed on the high rigidity confined-reinforced earth


          consisting of the crushed stone sandwiched by four layers of


          geosynthetics and confined by confining rigid anchors.


          We aimed at direct comparison of performance of the two


          pavement types by artificially generating the differential


          settlement of trial embankment such as often seen during severe


          earthquakes. The forced differential settlement of the


          embankment was realized by using 10 multi-controlled large


          hydraulic jacks supporting the steel deck (10m long) placed


          under the embankment body. The layout of the trial


          embankment is shown in Figure 2.


          Photograph 4. Trial embankment after testing of 550mm differential


          settlement.  (Confined –Reinforced Earth tested  in Ibaraki, Japan,


          2011)
